Revolutionizing Project Resilience through Advanced Risk Mitigation Strategy Launched
View article

Keywords

Project delays
Risk management
Construction projects
Mitigation strategies
Analytical methodologies

How to Cite

Oktaviana, H., & Jakaria, R. B. (2024). Revolutionizing Project Resilience through Advanced Risk Mitigation Strategy Launched. Indonesian Journal of Innovation Studies, 25(3), 10.21070/ijins.v25i3.1168. https://doi.org/10.21070/ijins.v25i3.1168

Abstract

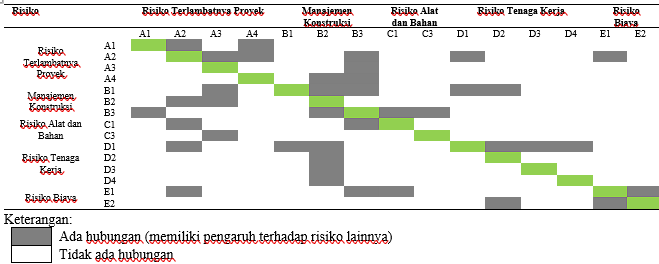

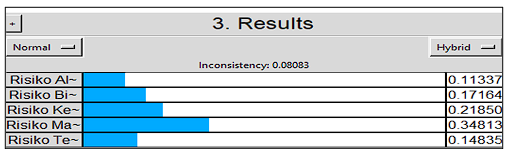

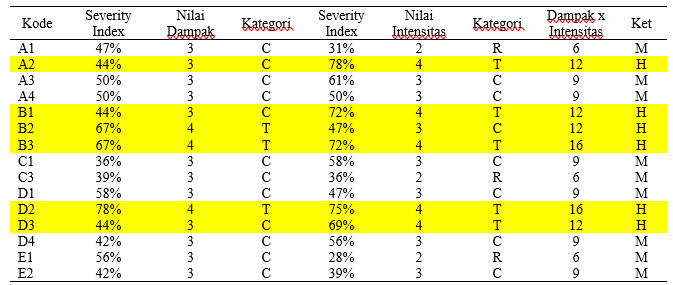

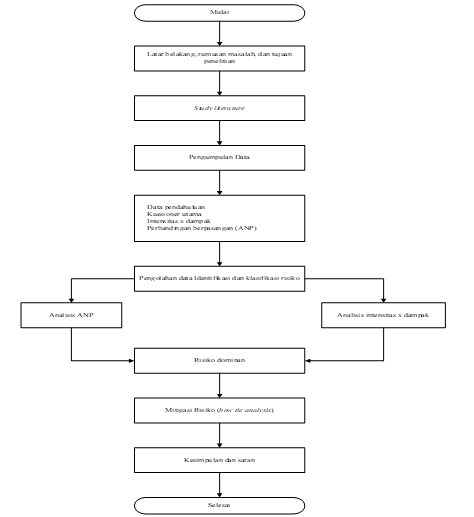

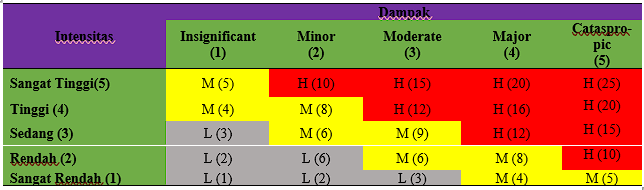

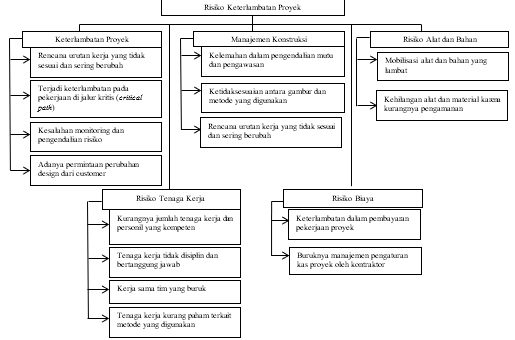

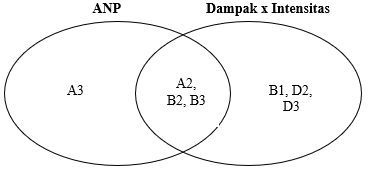

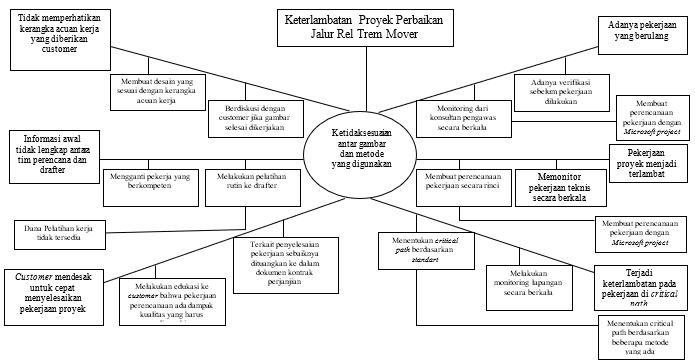

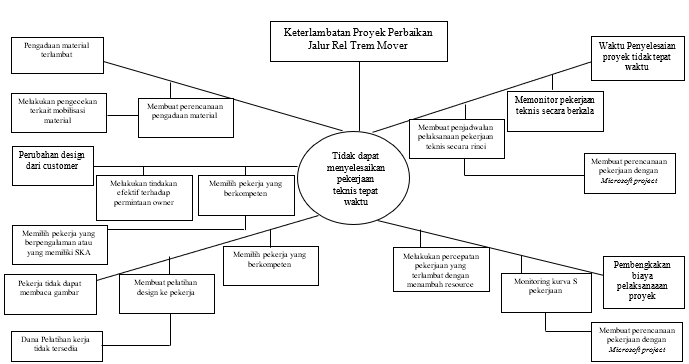

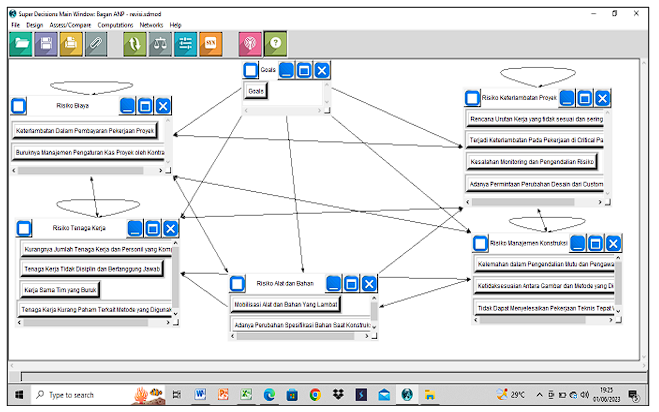

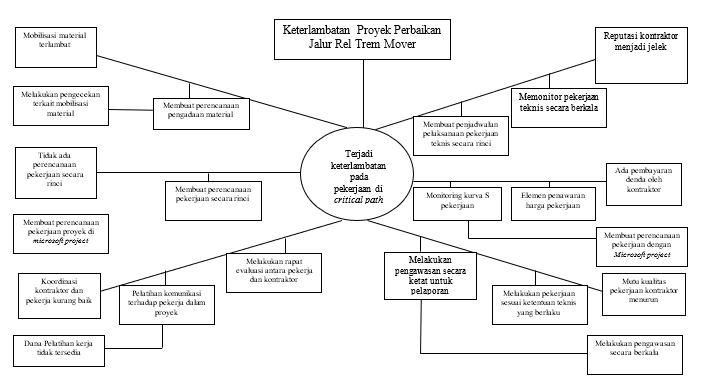

This study examines the risks associated with project delays in the Mover Tram rail line repair project at TMII and proposes mitigation strategies using a combination of Risk Breakdown Structure (RBS), Analytical Network Process (ANP), and Bow Tie Analysis methodologies. Through expert interviews, questionnaires, and document analysis, key risks were identified and prioritized. Results indicate that construction management emerged as the dominant risk group, with specific risks including delays in critical path tasks and discrepancies between drawings and methods. Mitigation strategies were developed focusing on these dominant risks. The study underscores the importance of integrating diverse risk assessment techniques for effective project management and suggests avenues for future research to enhance risk management frameworks in construction projects.

Highlights:

1. Integrated risk analysis enhances project resilience.
2. Construction management pivotal for identifying and mitigating project risks.
3. Future research: Explore cost-related risks for improved project outcomes.

Keywords: Project delays, Risk management, Construction projects, Mitigation strategies, Analytical methodologies

https://doi.org/10.21070/ijins.v25i3.1168
View article

References

PT. IMSC, "Proposal Jasa Konsultansi Pendampingan Pelaksanaan Proyek Tramover," 2022.

E. Rita, N. Carlo, and Nandi, "Penyebab Dan Dampak Keterlambatan Pekerjaan Jalan Di Sumatera Barat Indonesia," J. Rekayasa, vol. 11, no. 1, pp. 27–37, 2022, doi: 10.37037/jrftsp.v11i1.94.

S. Irmawati, "Analisis Manajemen Risiko Pada Proyek Dengan Sistem Kontrak Lumpsum (Studi Kasus: Proyek Pembangunan Jalan Tol Bekasi-Cawang-Kampung Melayu)," J. Poli-Teknologi, vol. 20, no. 1, pp. 15–26, 2021, doi: 10.32722/pt.v20i1.2933.

Project Management Institute, "A Guide to the Project," 2008.

B. Darma, "Statistika Penelitian Menggunakan SPSS," Guepedia, 2021. [Online]. Available: https://books.google.co.id/books?hl=id&lr=&id=acpLEAAAQBAJ&oi=fnd&pg=PA3&dq=Darma,+B.+2021.+Statistika+Penelitian+Menggunakan+SPSS.+Guepedia:+Jawa+Barat.&ots=IYq7WVgpX0&sig=SNczMZaTMN4betcjn42WURt-pAY&redir_esc=y#v=onepage&q&f=false

S. S. Syahrial Sidik and W. Wahyuari, "Manajemen Risiko Sistem Informasi Ujian Secara Daring Di Sekolah Tinggi Manajemen Asuransi Trisakti," J. Green Growth dan Manaj. Lingkung., vol. 12, no. 1, pp. 84–97, 2023, doi: 10.21009/10.21009/jgg.v12i1.06.

T. Noviyanti, "Sistem Penunjang Keputusan Dalam Penerimaan Beasiswa Ppa Menggunakan Metode Analytic Hierarchy Process (Ahp) (Studi Kasus: Universitas Gunadarma)," J. Ilm. Teknol. dan Rekayasa, vol. 24, no. 1, pp. 35–45, 2019, doi: 10.35760/tr.2019.v24i1.1932.

A. Priyambada, "Manajemen Risiko Dan Analisis Keputusan Solusi Material Obsolete Mechanichal Menggunakan Metode Hor Dan Anp (Studi Kasus: Pt Xyz)," J. Ind. Eng. Manag., vol. 5, no. 1, pp. 1–9, 2020, doi: 10.33536/jiem.v5i1.428.

L. Y. Sipayung, "Aplikasi Sistem Pendukung Keputusan Pemilihan Perusahaan Ekspedisi Terbaik Menggunakan Metode Analytic Network Process (ANP)," vol. 11, no. 01, pp. 79–88, 2019.

P. Rahman, "Analisa Resiko Pada Proyek Pembangunan Instalasi Pengolahan Air Limbah Di Kota Pekanbaru," vol. 8, no. 1, pp. 48–51, 2020.

N. N, M. Basuki, and I. S. Pramudya, "Penilaian Risiko K3 Pada Penyeberangan Ketapang-Gili Manuk Menggunakan Bow-Tie Risk Assessment," Prosiding, Semin. Teknol. Kebumian dan Kelaut. (SEMITAN III), vol. 03, no. 1, pp. 237–243, 2021.

W. Rasbora and B. Puintius, "Digital Digital Repository Repository Universitas Universitas Jember Jember Digital Digital Repository Repository Universitas Universitas Jember Jember," 2015.

E. R. Agung Prasetyo and L. B'tari Setyaning, "Literature Review: Analisis Manajemen Risiko Pada Proyek," J. Renov., vol. 8, no. 1, pp. 47–51, 2023, doi: https://doi.org/10.30738/renovasi.v8i1.14425.

C. Natalia, C. W. Oktavia, W. V. Makatita, and F. Suprata, "Integrasi Model House of Risk Dan Analytical Networking Process (ANP) Untuk Mitigasi Risiko Supply Chain," J. Metris, vol. 22, no. 01, pp. 57–66, 2021, doi: 10.25170/metris.v22i01.2619.

Y. O. L. Tobing, D. P. Sari, and P. A. Wicaksono, "Analisis Risiko Proyek Konstruksi Dengan Importance Index dan Bow Tie Analysis," Ind. Enginerring Online J., vol. 7, no. 4, pp. 1–8, 2018.

Creative Commons License

This work is licensed under a Creative Commons Attribution 4.0 International License.

Downloads

Download data is not yet available.

Metrics

Metrics Loading ...
